What is conservation project management?
Quick answer
Conservation project management is a structured approach to planning, funding, implementing, and evaluating wildlife conservation work within defined schedules and budgets to achieve measurable impact. Unlike generic project management, it accounts for biological uncertainty, complex stakeholder dynamics, and the ethical imperative to act despite incomplete information. The WildTeam framework breaks projects into five phases (Plan → Fund → Prepare → Implement → Close), guided by four principles that help teams adapt to changing conditions while maintaining focus on conservation results.
Source: WildTeam. (2026). Project Management for Wildlife Conservation v5. WildTeam UK, Cumbria, UK.
All WildTeam best practices are grounded in an extensive review of the relevant scientific and professional literature and are peer-reviewed by conservation experts from across the sector to ensure accuracy, practicality, and global applicability.
Source: WildTeam. (2026). Project Management for Wildlife Conservation v5. WildTeam UK, Cumbria, UK.
All WildTeam best practices are grounded in an extensive review of the relevant scientific and professional literature and are peer-reviewed by conservation experts from across the sector to ensure accuracy, practicality, and global applicability.
Access this best practice as part of the Project Management for Wildlife Conservation course.
UNLOCK OUR FULL BEST PRACTICES AND GET CERTIFIED CONSERVATION SKILLS
Ready to go deeper?
Build practical skills for wildlife conservation by exploring our expert-led courses designed to help you apply what you’ve learned in real-world contexts. From career development to technical conservation tools, our training is built to support your next step.
Contents
-
Why standard project management fails conservation
-
The 4 principles that make conservation projects work
-
Who does what: conservation project roles
-
The 5 conservation project phases explained
-
Keeping projects on track: The 3 control processes
-
Common conservation project pitfalls
-
Getting started: your first conservation project
-
FAQ
Why standard project management fails conservation
Given current rates of biodiversity loss, conservation work has never been more important. However, conservationists face a critical challenge: 90% of conservation funds support projects that have no means to verify the effectiveness of their efforts.
This isn't because conservationists lack dedication. The problem lies in applying project management approaches designed for business and technology that don't account for conservation's unique challenges:
• Biological uncertainty: Conservation projects operate in complex ecological systems where cause-and-effect relationships are difficult to predict. You might discover mid-project that the threat you identified isn't the primary driver of decline.
• Ethical urgency: Unlike business projects that can be delayed for better conditions, conservation projects face the reality that biodiversity continues to degrade while teams wait for perfect information.
• Resource constraints: Conservation organisations operate with limited budgets and staff, under constant pressure to demonstrate impact. Time wasted on ineffective approaches directly harms wildlife.
• Complex stakeholder landscapes: Projects must navigate relationships with local communities, government agencies, donors, researchers, and the wildlife itself—each with different needs and definitions of success.
Research shows that 66% of conservationists assess themselves as having insufficient competency in project management skills, despite 98% believing these skills are essential for effectiveness. This skills gap helps explain why so many well-intentioned efforts fail to achieve measurable impact.
The 4 principles that make conservation projects work
Do something: act despite uncertainty: If you wait for perfect information, biodiversity continues degrading. Start addressing threats early, prioritise high-confidence work packages, and conduct research to fill gaps and guide later activities.
Focus on impact: outcomes over activities: Place more importance on conservation outcomes than activity completion. A project that delivers training on time but doesn't improve skills has failed. Success is achieving conservation impact, even if the path looked different from the original plan.
Take responsibility: clear accountability: Every team member must know what decisions they can make and what work they're responsible for. This requires well-defined roles, documented line management, and single ownership for every task.
Embrace change: adapt to new information: Welcome and adapt to changing conditions rather than rigidly following outdated plans. Every risk, issue, opportunity, and lesson learned gets documented, assessed, and assigned a formal response. When something has a "high" rating, the project is "in exception" and requires updating the plan or closing.
See the best practice for a deep dive into how these shape successful projects.
See the best practice for a deep dive into how these shape successful projects.
Who does what: conservation project roles
Project team roles:
- Project director is ultimately accountable for delivery. They decide whether to update the project plan and when to close the project.
- Project planner produces the project plan and raises funds during Plan and Fund phases.
- Project manager runs day-to-day operations from Prepare through Close phases. They make decisions about daily work as long as the project remains on track.
- Project support assists the project manager with control processes.
- Workstream leader manages day-to-day operations for related work packages.
- Workstream member delivers assigned milestones and tasks.
Enabling roles:
- Leader manages the organisation and decides on responses to risks affecting organisational reputation.
- Operations support provides guidance on finance, human resources, or other functional areas.
- Project assurance conducts objective assessments of adherence to the project plan, typically for high-budget projects.

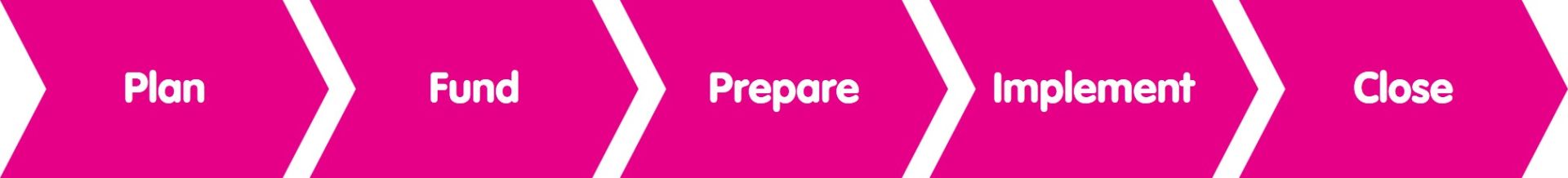

The 5 conservation project phases explained

The WildTeam five-phase framework organises conservation work into five sequential phases, each with specific activities and clear authorisation gates.
Plan: creating the project blueprint: The Plan phase produces your project plan—the document defining what you're trying to achieve (conservation impact), how you'll achieve it (work packages), when (schedule), and what it will cost (budget).
Key activities include mobilising the project director and project planner, setting up the project tracker, establishing control processes, and producing a signed-off project plan. The plan includes your conservation strategy, monitoring and evaluation framework, roles, stakeholder engagement approach, risk assessment, work plan, and budget. Critical concept: tolerance limits. These are acceptable deviation ranges for project parameters. If your objective is "increase awareness by 20%", tolerance limits might be 15–25%. Within tolerance, no plan update is needed. Outside tolerance, a formal change process is required.
Fund: securing financial resources: The Fund phase identifies donors and secures funding for subsequent phases. You may apply to multiple donors—one funding law enforcement work packages, another funding research.The crucial decision: what if you've secured only 60% of your budget? The project director must decide whether to wait, start with fully funded work packages and stage others later, or accept accountability for the gap and proceed. Starting with less than 50% funding is generally irresponsible—projects collapse mid-implementation.
Prepare: mobilising your team: The Prepare phase gets your team ready through detailed planning and process establishment. The project manager is mobilised, the project tracker is populated, and workstream leaders break work packages into activities, milestones, and tasks.This phase transforms strategic plans into operational reality. Each piece of work gets assigned to a single owner with specific deadlines.
Implement: delivering conservation work: The Implement phase is where actual conservation happens—protecting wildlife, restoring habitats, changing behaviours, reducing threats. This typically lasts three to four years. Critical success factor: every milestone and task must have exactly one owner. This prevents the “I thought you were handling that” problem that causes work to fall through gaps.
Close: evaluating and transferring knowledge: The Close phase formally ends the project through evaluation, stakeholder reporting, and knowledge transfer. The project-end report compares achieved impact versus planned impact.
IMPORTANT: project end doesn't mean conservation work ends. It provides a checkpoint to decide whether to continue with another project, pivot to a different threat, or close the programme if the biodiversity target is secure.
Keeping projects on track: The 3 control processes
Managing progress: Regular status meetings review completed work, plan upcoming activities, and assess whether the project is on track. Typical structure: weekly workstream meetings, monthly project-level meetings, quarterly strategic reviews, annual evaluations.
Before meetings, team members update the project tracker. During meetings, the chair facilitates discussion and the notetaker captures actions and decisions.
Managing change: This process enables adaptation through structured handling of risks, issues, opportunities, and lessons learned.
Team members identify and categorise new information. The project manager scores effect and likelihood to calculate an overall rating. If a risk, issue, or opportunity has a "high" rating after the planned response, the project is "in exception"—you cannot achieve the signed-off plan. When in exception, the project manager produces an exception report and adaptation plan. The project director decides whether to authorise the plan update or close the project.
Managing adherence: For large, high-budget projects, independent project assurance verifies adherence to the plan through assurance reports. This is optional for most projects.
Common conservation project pitfalls
Paralysis from uncertainty: Waiting for perfect information while biodiversity degrades. Apply "do something"—start high-confidence activities while researching.
The activity trap: Delivering activities without achieving conservation impact. Success is measured by impact, not completed tasks.
Role confusion: Multiple people thinking they're in charge, duplicated effort, missed deadlines. Document roles clearly with explicit line management.
Ignoring warning signs: Small problems growing into crises. Status meetings catch these early—address them immediately.
Insufficient funding: Starting with less than 50% budget secured, hoping funds will materialise. Projects collapse, leaving incomplete work.
Rigid plan worship: Treating the plan as unchangeable rather than a baseline to be updated through structured processes.
Getting started: your first conservation project
For standard projects (5+ people, $50,000+ budget):
For solo or small projects (1–3 people, under $50,000):
Available resources
Free templates for all project documents are available with the Project Management for Wildlife Conservation best practice and course.
Developing strong project management skills is one of the most powerful ways to make conservation work more effective. These skills improve how you plan, coordinate, and evaluate your work, helping you and your teammates avoid wasted effort, communicate more clearly, and achieve stronger, measurable impact for wildlife. The Project Management for Wildlife Conservation online course provides interactive modules that teach these practical skills—essential for any conservation professional or team aiming to deliver results confidently and collaboratively.
Minimum documentation: Project plan, project tracker (at minimum: work plan and impact tabs), project-end report.
Minimum roles: Project director, project manager, workstream leaders if work naturally clusters.
Minimum processes: Regular status meetings, formal risk/issue documentation.
Minimum phases: Complete Plan and Fund before Prepare. Don’t start Implement until Prepare is complete.
For solo or small projects (1–3 people, under $50,000):
Create a five-page project plan with essentials. Use only work plan and impact tabs of tracker. Assign yourself all roles. Update tracker weekly (30 minutes). Follow all four principles but streamline processes.
Available resources
Free templates for all project documents are available with the Project Management for Wildlife Conservation best practice and course.
Developing strong project management skills is one of the most powerful ways to make conservation work more effective. These skills improve how you plan, coordinate, and evaluate your work, helping you and your teammates avoid wasted effort, communicate more clearly, and achieve stronger, measurable impact for wildlife. The Project Management for Wildlife Conservation online course provides interactive modules that teach these practical skills—essential for any conservation professional or team aiming to deliver results confidently and collaboratively.
UNLOCK OUR FULL BEST PRACTICES AND GET CERTIFIED CONSERVATION SKILLS
Ready to go deeper?
Build practical skills for wildlife conservation by exploring our expert-led courses designed to help you apply what you’ve learned in real-world contexts. From career development to technical conservation tools, our training is built to support your next step.
FAQ
What's the difference between a conservation project and a programme?
Yes, but streamline them. Even solo projects need planning, funding, preparation, implementation, and closure—just with lighter-weight processes.
Do I need all five phases for small projects?
WildTeam have developed a range of vocational courses in such topics as project management, project planning, monitoring and evaluation, leadership, and grant writing. WildTeam will continuously strengthen these courses and create new ones in response to the needs of the network.
Can one person hold multiple roles?
Yes. On small projects, one person might be project director, project manager, and workstream member. However, every task must still have exactly one owner.
What if I can’t secure full funding before starting?
The project director decides whether to wait, start with fully funded work packages only, or accept accountability for the gap. Starting below 50% funding is high risk.
How do I know if my project is in exception?
When a risk, issue, or opportunity has a "high" rating even after your planned response, you're in exception. This means you cannot achieve the project plan and must either update it or close the projec
What's the minimum documentation needed?
Every project needs: project plan (blueprint), project tracker (day-to-day management), and project-end report (evaluation). Everything else is optional depending on scale and complexity.
How often should I hold status meetings?
Depends on project complexity. More complex projects need more frequent meetings. Typical: weekly workstream meetings, monthly project-level meetings, quarterly reviews.
When should I update my project plan?
Only through the formal managing change process when a high-rated risk, issue, or opportunity puts the project in exception. The project director must authorise all plan updates.
How do tolerance limits work?
They’re acceptable deviation ranges for parameters. If your 20% awareness increase objective has 15–25% tolerance limits, achieving 17% is success. Achieving 12% triggers formal plan review.
Can I use this framework for both small and large projects?
